Trust

Acrylic Block RMA — Defect Categories We Accept Returns On

Most return disputes come from buyers and suppliers reading different rulebooks. Here is the rulebook we publish before you place an order — what counts as a defect, what we replace, what we refund, and how long every step takes.

QC inspector examining a clear acrylic block under raking light at the inspection station, with calipers and a defect-classification card visible — Wetop Acrylic RMA defect inspection

Key Takeaways

  1. We classify acrylic block defects into 8 categories — internal bubbles, edge chips, surface scratches, dimensional drift, polish haze, color bleed, bond-line voids, and shipping fracture — and the table below tells you which are eligible for RMA before you order.
  2. The inspection window is 14 calendar days from delivery. Notify us inside that window with the photo evidence package and the RMA pathway opens automatically; outside it, we still help, but on goodwill, not policy.
  3. Replacement is the default response on production-side defects; refund is the default on shipping-side fracture where re-production is too slow to fit your launch date. We confirm which path within 48 hours of the photo evidence arriving.
  4. Across the 1,000+ orders my team has inspected piece-by-piece since 2016, the RMA-rate has held under 0.8% on standard production — the policy below is built around that distribution, not a worst-case guess.
  5. Repeat-buyer SLA is 48-hour first response and 7 working days to ship a replacement on stock material; we publish it because you need a number to plan a launch around, not a maybe.
On this page
  1. The 8 defect categories — what’s eligible, what’s not
  2. The 14-day inspection window — operational, not legalistic
  3. Replacement vs refund — when each applies
  4. Photo evidence — the four shots that move the claim fast
  5. Repeat-buyer SLA — the 48-hour first response standard
  6. Related guides

I run quality control for Wetop Acrylic. Across the 1,000+ orders my team has inspected piece-by-piece since 2016, the RMA-rate has held under 0.8% on standard production — and most return disputes I’ve watched at other factories don’t actually come from defect rate. They come from buyer and supplier reading different rulebooks.

So we wrote the rulebook down. The eight defect categories below are exactly what my QC station inspects against on every block before it leaves Shenzhen. The 14-day window, the replacement-vs-refund logic, the photo evidence list, and the 48-hour SLA are exactly what we apply when something does come back. Publishing this before you place an order means you know what you’re buying, and we know what we’re committing to. That’s the deal.

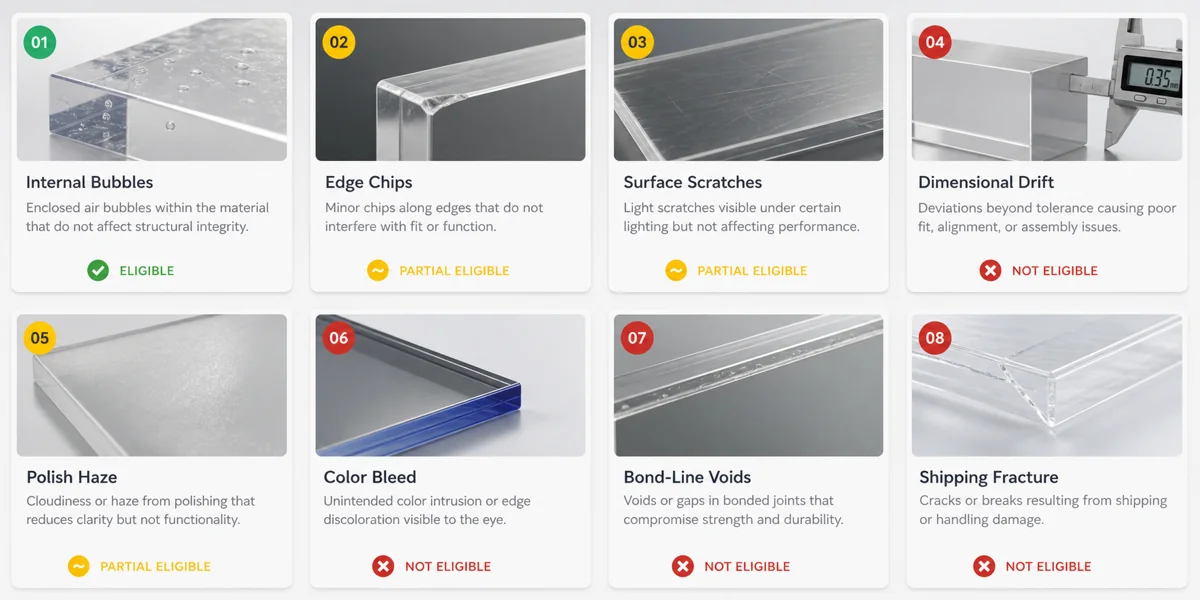

8 acrylic block defect categories arranged in a 4-by-2 grid — internal bubbles, edge chips, surface scratches, dimensional drift, polish haze, color bleed, bond-line voids, and shipping fracture — each card shows category name, brief description, and an RMA-eligibility status icon
The 8-category defect taxonomy our QC line inspects against on every acrylic block — eligibility status published before you order, not negotiated after.

The 8 defect categories — what’s eligible, what’s not

Acrylic block defects don’t all carry the same root cause, the same visibility, or the same fix path. Lumping them together as “quality issues” is what makes RMA conversations slow and tense. We split them into eight categories, each with its own threshold and its own RMA status.

The table is the contract. If a defect on your shipment matches the description in column 1 and column 2 says “Yes,” the RMA pathway opens automatically once we have the photo evidence. If column 2 says “No” or “Conditional,” we still respond — but you’ll know going in why the answer might not be a replacement.

#CategoryDescriptionRMA EligibleMitigation we run upstream
1Internal bubblesTrapped air or solvent vapor visible inside the block, individual bubble diameter >0.3mm or cluster covering >5% of any faceYesVacuum degas during cast cure; reject sheet at incoming if >2 bubbles per square foot
2Edge chipsChip on cut edge deeper than 0.2mm or longer than 2mm, visible without magnificationYesCNC feed-rate tuned per thickness; chamfer pass after rough cut on edges >10mm
3Surface scratchesScratches visible under standard office lighting (500 lux) at 50cm viewing distance, on any A-faceYesProtective film stays on through every station; final film peel at packing only
4Dimensional driftOutside the quoted tolerance — typically ±0.2mm on dimensions <100mm and ±0.5mm aboveYesCalibrated calipers logged at each shift start; first-article check before lot release
5Polish hazeCloudy or milky appearance on a face spec’d as optically clear, covering >5% of the faceYesDiamond polish parameters logged; flame polish reserved for edges only, never faces
6Color bleedDyed or printed color migrating outside intended boundary on multi-color blocks; UV-print misregistration >0.3mmYesColor-fast pigments only on dyed cast; UV ink cured at full lamp power, not reduced
7Bond-line voidsVisible gap, bubble, or haze line in a solvent-welded or laminated joint on a multi-layer blockYesSolvent cement applied at controlled flow rate; capillary fill verified before clamp
8Shipping fractureCrack or break clearly traceable to in-transit impact (carton damage, corner crush)Conditional — eligible if 14-day window met and carton damage photographedFoam corner blocks + double-wall carton; carton drop-test sample per quarter

Three patterns to read in this table:

The first six categories are production-side and unconditional. If we shipped them, they’re our responsibility. The mitigation column tells you what we already do upstream — not as marketing, but so you can match against your incoming-inspection plan and decide whether to add a step on your side.

Bond-line voids matter more on laminated blocks. A single-piece cast block won’t ever fail this category. But if your design is a 3-layer trophy block or a logo block with an embedded color layer, the bond line is where defects concentrate. We log every bond run; for high-stakes orders we send a pre-ship video on request.

Shipping fracture is conditional, not automatic. The condition is photo evidence of the carton exterior alongside the broken piece, taken within 14 days. With that evidence, the claim is ours to handle (we own the carrier relationship). Without it, the claim becomes ambiguous and slow.

What’s not on this list, and why. Cosmetic micro-marks below the standard-lighting visibility threshold are inside the natural variance of cast acrylic. Stress cracks from drilling, over-tightened fasteners, or solvent contact after delivery are end-use conditions, not factory defects. We’ll always help diagnose, but the warranty boundary stops at delivery condition.

The 14-day inspection window — operational, not legalistic

Every RMA policy needs a clock, and the clock has to be fair to both sides. Ours is 14 calendar days from the carrier’s delivery scan. Here’s why that number, in operational terms.

Below 7 days is too tight for buyers — your warehouse takes time to open a freight delivery, your QC may run on a weekly cycle. Above 30 days makes the supplier’s job impossible — the goods have moved through your floor and we genuinely cannot tell whether a chip happened in our packing line or on someone’s forklift. 14 days is the window where the evidence is still clean.

Inside the window, the policy obligation is automatic. Photo evidence arriving at day 11 triggers the same response path as one arriving at day 2. Outside the window, we still review every claim on goodwill, but I treat those as judgement calls rather than policy commitments.

A practical clause for buyers with long internal QC cycles: if your standard incoming-inspection pattern is monthly, tell us at quote time and we’ll extend the window to 30 days in writing on that order. We’ve done this for six buyers over the last three years — usually distributors with regional 3PL warehouses.

Document timing matters too. We mark “delivery date” as the carrier’s scan, not the day the goods reach your final stocking location.

Replacement vs refund — when each applies

Once a defect is confirmed inside the 14-day window, the next decision is the pathway: replacement or refund. The default is replacement; the exceptions are real but specific.

Replacement is the default on production-side defects: re-running on the same tooling is the fastest path back to a buyer who already specced and approved the design. Lead time is typically 7 working days for stock material, 10–14 days on custom dyes or thicker cast, with air freight at our cost. The replacement quantity matches the affected pieces; we don’t ask you to wait for a full re-run.

Refund overrides replacement in three specific situations:

  1. Launch date can’t accommodate re-production. If your retail rollout ships June 1 and the defect arrives back May 26, even a 7-day replacement misses the install window. Refund for the affected units; ship the defective pieces back as fallback inventory rather than scrap when it makes sense.
  2. One-off orders where re-production economics fail. A 12-unit prototype run with a custom mold doesn’t justify rebuilding the mold for a 1-unit replacement.
  3. Shipping fracture above ~30% of the shipment. When the cost of re-running and re-shipping exceeds order value, refund plus a fresh quote on the next PO is the cleaner answer.

We confirm the pathway in writing within 48 hours of the photo evidence arriving — path, quantity, timeline, and disposition of the defective pieces. You don’t have to argue any of it; the policy decides.

For buyers building their own internal procurement playbook, this pathway logic mirrors the ISO 10002 customer complaints handling framework — published response time, documented decision criteria, no asymmetric bargaining at the point of failure.1 We didn’t invent it; we just hold ourselves to it.

Photo evidence — the four shots that move the claim fast

The single biggest reason RMA claims drag is incomplete evidence. The buyer sends one tight close-up of a chipped corner; the supplier asks for the carton, the packing layer, and a wide shot; three days pass while the photos travel back and forth. We’ve cut that loop by publishing exactly what we need up front.

Four shots, every claim, every time:

  1. Carton exterior. All sides of the outer carton, shot in normal light. We’re looking for impact marks, corner crush, water damage, or a clean carton (which tells us the defect is production-side, not shipping). Don’t open the box first if you can avoid it — we want the carton documented before any opening damage is added.
  2. Packing layer with goods in place. Lift the top foam or kraft layer and shoot the goods as they sat in transit. This shows whether internal packing failed, shifted, or was insufficient.
  3. The defective piece against a ruler. Place a metric or imperial ruler next to the defect at the same plane. Shoot at 90 degrees, in normal light. Macro is fine, but include enough context that we can match the defect location to our inspection record.
  4. Wide shot showing scope. One photo that shows how many pieces are affected, ideally with affected pieces grouped on one side and unaffected pieces on the other. This is the shot that determines partial vs full RMA quantity.

Phone camera is fine. Daylight or office overhead lighting beats flash, which hides scratches and emphasizes glare. If a defect only shows under raking light (low-angle illumination, common on surface scratches), one extra shot under a desk lamp angled across the surface usually catches it.

For buyers running a high-volume inspection line, see how we structure our own inspection records in our ISO 9001 acrylic manufacturer guide — the photo evidence requirements above mirror our internal QC documentation, so your incoming-inspection photos flow straight into our root-cause analysis without translation. We send a one-page photo template PDF on first orders. It cuts average claim resolution from 8 working days to under 4 in our experience.

Repeat-buyer SLA — the 48-hour first response standard

A defect policy that takes a week to respond is not really a policy; it’s a backlog. We publish a 48-hour first-response SLA on every RMA from a buyer who has placed at least one prior order — and a 72-hour SLA on first-time buyers, where the relationship setup adds a step.

The clock starts when complete photo evidence arrives in our inbox. Within 48 hours we send: confirmation that the claim is logged, the pathway decision (replacement or refund), the timeline (ship date for replacement, refund processing date), and the disposition of the defective pieces (return at our cost, hold for inspector, or local disposal).

Why publish a number? Because every buyer planning a launch needs a known floor on how long a quality issue can hold them. “We’ll respond as soon as we can” doesn’t help your project plan. 48 hours does.

Beyond the first response, the rest of the timeline looks like this on a typical case:

  • Day 0: Photo evidence received and acknowledged.
  • Day 0–2: Pathway decision sent (replacement / refund / conditional).
  • Day 2–9: Replacement production run on stock material — 7 working days standard.
  • Day 9–12: Air-freight transit at our cost; we don’t downgrade to ocean to save money on a defect order.
  • Day 12–14: Buyer confirms receipt; corrective action report (CAR) sent if the defect rate on the batch exceeded 2%.

For repeat buyers running quarterly or seasonal orders, this SLA is what closes the loop on the supplier-evaluation side. We’ve seen the ISO 9004:2018 quality management framework treat published response times as a sustained-success indicator — defined response, documented decision, traceable execution.2 We treat it the same way: a slow defect response on order #2 is a louder signal about partner quality than a clean order #1. We’d rather you measure us on the bad day.

For an example in practice, see our acrylic cosmetic organizers with velvet inserts case study — there’s a sidebar on how we handled a 6-piece edge-chip RMA on the second shipment without slipping the buyer’s retail launch date. Same policy, same timeline, written down, executed.

A published policy handles the median case. The hard cases — where the defect is ambiguous or the photo evidence is partial — are where text alone doesn’t carry the day. For those, our default is to do more, not less: if photo evidence is incomplete and we can’t make a confident pathway decision, we ship a replacement at our cost and ask for the missing evidence after, not before. We’ve eaten the cost on roughly 1 in 30 RMA cases over five years; the math still works. What we ask in return is that when a defect is on us, you tell us plainly — we’d rather know about a 0.8% RMA than discover at month 6 that a buyer quietly switched suppliers because the policy felt one-sided.

If you want the full RMA policy as a one-page PDF in your supplier file, or want to talk through a specific block design (custom dye, multi-layer bond, oversized cast), send us your project brief and I’ll attach the document to the first reply alongside the production sample plan. Same for buyers comparing our acrylic blocks product range against another quote — if the other supplier hasn’t published their RMA policy in writing, that absence is itself a data point worth weighing.

Footnotes

  1. International Organization for Standardization. ISO 10002:2018 — Quality management — Customer satisfaction — Guidelines for complaints handling in organizations. https://www.iso.org/standard/71580.html — defines the documented response-time and decision-criteria framework that our 48-hour SLA and pathway logic are modeled on.

  2. International Organization for Standardization. ISO 9004:2018 — Quality management — Quality of an organization — Guidance to achieve sustained success. https://www.iso.org/standard/70397.html — the supplementary standard to ISO 9001 that treats published response times and traceable corrective actions as sustained-success indicators, not optional add-ons.

Share this guide

Frequently Asked Questions

What acrylic block defects are eligible for RMA?

Production-side defects that breach our published tolerance — internal bubbles above 0.3mm, edge chips deeper than 0.2mm, surface scratches visible under standard office lighting, dimensional drift outside the quoted tolerance, polish haze across more than 5% of any face, color bleed on dyed or printed blocks, and bond-line voids on multi-layer constructions. Shipping fracture is also eligible when the carton shows external impact and the photo evidence arrives within 14 days. Cosmetic micro-marks below the visible-defect threshold, customer-induced damage after delivery, and stress-cracking from end-use overload are not eligible. The full 8-category table earlier in this guide lists each category with its RMA status.

How long is the inspection window for an acrylic block RMA?

14 calendar days from the carrier's delivery scan. Inside that window, you send the photo evidence package (carton exterior, packing layer, the defective piece against a ruler, and a wide shot showing how many pieces are affected) and the RMA pathway opens automatically. Outside the window, we still review case-by-case on goodwill — but the policy obligation lapses at day 15 because by then it is genuinely difficult to separate a production-side defect from handling damage on the buyer's floor.

Will I get a replacement or a refund?

Replacement is the default on production-side defects because re-running on the same tooling is faster and matches your project specs exactly. Refund is the default when the production lead time would miss your launch date, when the order is a one-off and re-production economics don't work, or when shipping fracture is widespread enough that re-running and re-shipping costs exceed the order value. We confirm which path you're on within 48 hours of receiving the photo evidence — you don't have to argue it.

Do I have to ship the defective acrylic block back?

Usually no. For most acrylic block defects under $200 unit value, photo evidence is enough — return shipping costs more than the goods, and we'd rather you dispose of or recycle the defective pieces locally. For higher-value blocks or multi-piece RMA claims, we sometimes ask you to hold them for a third-party inspector or ship one representative sample back at our cost. We tell you which route on the 48-hour response, never after.

What if my defect rate is higher than the 0.8% RMA-rate Wetop quotes?

Then something went wrong on a specific batch and we treat it as a process failure, not a statistical fluctuation. Above 2% defect rate on any single shipment we open an internal corrective action: I personally review the inspection record for the batch, we trace the failure to a station and a shift, and we issue a Corrective Action Report (CAR) that goes to the buyer alongside the replacement shipment. The 0.8% number holds because we treat outlier batches as failures of the system, not as acceptable variance.

Want the full RMA policy in your supplier file?

We send the 8-category defect taxonomy, the 14-day inspection clause, and the 48-hour SLA as a one-page PDF on every quote above five figures. Tell us your project and we'll attach it to the first reply, alongside the production sample plan.
