Mirror-Finish Acrylic Sneaker Pillar Manufacturing Plan

This Manufacturing Case shows how a retail buyer can plan a mirror-finish sneaker pillar around the actual shoe envelope, store sightline, base footprint, shelf layout, surface sample, cleaning method and packing brief. It is a production-planning model, not a completed buyer shipment or a claim about sales performance.

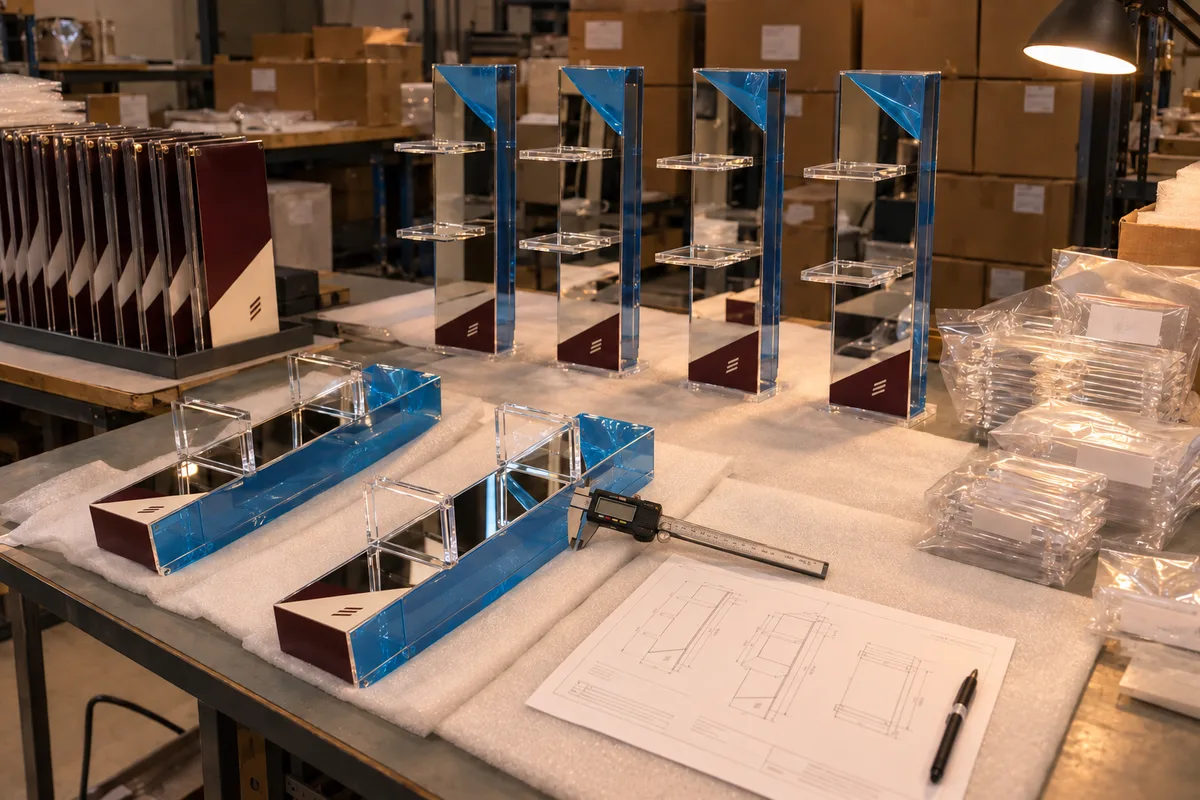

Four mirror-finish acrylic sneaker display pillars in graduated heights with burgundy-and-cream branded base panels
pieces per design
100+
surface approval
Sample-led
standard production
15–20 days
complete-brief response
24 hours
100
MOQ (pcs)
3-5d
Sample lead time
15-20d
Production lead time
24h
Quote response

MOQ is 100 pieces per design. Paid samples normally take 3–5 days; sample fees are paid separately and never credited. Standard production takes 15–20 days after the drawing, material, surface sample, inspection plan and packing are approved. Wetop responds to a complete brief within 24 hours.

Different-specification price reference: the acrylic displays hub publishes a $20–40 per-unit planning band for a typical custom display stand. That reference is not a mirror-finish sneaker pillar quote; final pricing depends on the released geometry, material, finish, artwork, protection and packing.

Key Takeaways

  1. Treat mirror finish as a sample-controlled visual specification. The approved physical sample, named sheet, viewing light and cleaning method define acceptance.
  2. The buyer supplies the shoe envelope, viewing height, shelf count, base footprint, load case and store constraints before a pillar drawing is released.
  3. Wetop supplies the non-electrical fabricated acrylic fixture. Powered lighting, wiring, certification and site installation stay outside this manufacturing plan.
  4. Production inspection records surface appearance, edge finish, shelf fit, base stability, artwork, protective film and packing against the approved drawing and sample.
  5. A repeat run reuses the released file only when the buyer confirms that geometry, material, finish, artwork, packing and destination requirements are unchanged.

The Brief

A useful mirror-pillar brief starts with the merchandise and site, not a supplier's standard size. The buyer should provide the largest shoe envelope, intended viewing height, number of display levels, available floor footprint, customer access rule, base fixing condition, artwork, cleaning method and destination list. Photographs and a simple store plan help the factory understand sightlines, nearby fixtures and collision risks.

The word “mirror” also needs definition. A buyer may mean a reflective acrylic face, a mirrored base, a reflective rear panel or a complete reflective shell. Those choices create different visual, fabrication, protection and packing requirements. The drawing should name each reflective face, each exposed edge and every surface that must remain protected until final placement.

This page models a multi-level freestanding pillar with buyer-selected mirror faces and branded base treatment. It does not prescribe a universal shelf count, material thickness, height or load. Those values depend on the actual shoe, access behavior, base support and approved sample. Wetop's scope is the non-electrical fabricated acrylic fixture; powered lighting, wiring, certification and site installation remain outside the plan.

Recommendation

Start with two layout options on the same store plan: a single-pair pedestal and a multi-level pillar. The buyer can compare viewing distance, merchandise density, staff access, customer reach and base footprint before selecting a format. This keeps the decision tied to the retail program instead of treating a taller fixture as automatically better.

For the mirror surface, approve the named sheet and a production-representative sample under the store's intended lighting. The review should cover reflection quality, visible distortion, edge appearance, color of any backing layer, artwork position and the effect of protective film. A screen rendering cannot establish those acceptance points.

The base and shelf system then follow the approved layout. A freestanding design needs a buyer-defined stability test based on the actual fixture, merchandise, access direction and site condition. Wall fixing or floor anchoring, if required by the buyer or local site rules, must be shown on the drawing and handled by the buyer's qualified installer.

Spec Breakdown

The RFQ should separate the pillar into controlled zones so the drawing, sample and inspection record use the same language. The shoe-display floating-effect guide provides the adjacent shelf, standoff, spacing and sample decisions; this Manufacturing Case adds the reflective surface, base and multi-level packing controls.

Base selected around the real site condition

The buyer defines the available footprint, finished floor, cleaning clearance, kick exposure and permitted fixing method. Wetop returns a base drawing that identifies the support structure, acrylic cover, artwork, access panels and contact surfaces. The sample review checks level, visible seams, finish and stability under the buyer-approved test method. No hidden cable channel is assumed because electrical integration is outside Wetop's scope.

Shelf geometry released from the shoe envelope

Each shelf position is drawn around the buyer's largest approved shoe or physical product sample. The buyer confirms toe and heel clearance, viewing angle, removal path, shelf spacing and customer reach. The drawing names the joint or mechanical support method; the physical sample confirms deflection, visible bond lines, edge finish and the way the product sits before bulk production.

Mirror faces approved as a visual system

Material grade, reflective face, backing color, exposed edges, branding and protective film belong on one finish schedule. If the fixture will stand near powered lighting supplied by others, the buyer should approve the surface under that light during sample review. Wetop does not supply an LED light box, wiring or electrical certification as part of this case.

The completed release file should include the dimensioned drawing, material schedule, finish sample, artwork revision, product envelope, stability test, inspection points, protective-film rule and packing diagram. That file is the shared reference for production and any unchanged repeat run.

Production and Mirror QC

Reflective faces should stay protected through cutting, fabrication, inspection and packing wherever the process permits. The inspection plan identifies which surfaces are viewed under buyer-approved lighting, the viewing distance, allowable appearance criteria and the handling method. These are project inputs, not universal mirror-quality thresholds.

First-off inspection checks overall geometry, shelf position, base level, joints, visible edges, finish, artwork and protective film against the approved drawing and sample. Production inspection repeats the buyer-approved sampling method and records any rework before packing. If a finish batch changes, the buyer decides whether a new swatch or sample approval is required.

Packing should prevent reflective panels, shelves, bases and hardware from rubbing against one another. The released packing diagram names protective film, sleeves, foam contact zones, cartons or crates, accessories and assembly instructions. Destination labels should distinguish each design and store allocation without relying on workers to infer contents from carton size.

Install Planning and Field Review

Before production release, the buyer should define who receives, assembles, fixes and signs off each unit. Site responsibilities, local requirements and any installer qualifications belong in the buyer's rollout plan.

If the retailer wants to measure commercial impact, it should set its own baseline, test stores, comparison window and metrics before deployment. Product interaction, sell-through and revenue can be affected by merchandise, stock, staff behavior, promotion and location. Wetop supplies the approved fixture and its manufacturing records, not a guaranteed retail result.

A useful receiving record checks carton identity, protective film, visible damage, component count, assembly fit and fixture stability. Any discrepancy should reference the design, revision, carton and photographs so the buyer and factory can separate production, packing, freight and site-handling issues.

Commercial status
Manufacturing plan, not a completed shipment
Production release
Approved drawing and production-representative sample
Inspection record
Surface, edge, fit, stability, artwork and packing checks
Repeat-order rule
Reconfirm every changed design and destination input
Approve the shoe envelope, store sightline, base condition, shelf layout and mirror sample before bulk. Keep electrical work and sales outcomes outside the acrylic manufacturing claim.
Buyer decision summaryMirror-finish sneaker pillar planning model

Lessons and Revision Control

The first lesson is to define “mirror finish” in a way that can be inspected. Name the sheet, reflective face, backing, lighting, viewing method and approved sample. A generic request for a premium reflection is not a production acceptance standard.

The second lesson is to separate format approval from finish approval. A pillar can pass its appearance review and still fail the buyer's shelf-access or stability test. A finish sample can also pass while the full-size geometry needs revision. Keeping those gates distinct makes corrective decisions traceable.

For future artwork or merchandise changes, compare the new brief with the released file. Unchanged geometry and material may support a repeat quote, but a new shoe envelope, shelf count, base condition, finish, artwork, packing method or destination requirement can reopen drawing and sample approval. The quote should state which files and setup items are reused.

Planning a sneaker display acrylic rollout?

Send the approved footprint, pillar height, shoe positions, mirror reference and packing constraints. We will review the brief and respond within 24 hours.

Paid sample in 3–5 days, separately paid and never credited · Production in 15–20 days after approval · MOQ 100 pieces per design
