Manufacturing Case · Technical / Industrial · Planning Model

Custom Acrylic Precision Component Manufacturing Plan

This manufacturing case is a planning model, not a completed OEM shipment. Wetop reviews the buyer's drawing, named material, measurement method, first-article format, finish, packing, and inspection plan before quoting or committing a tolerance. Bulk release follows the buyer-approved drawing and physical sample.

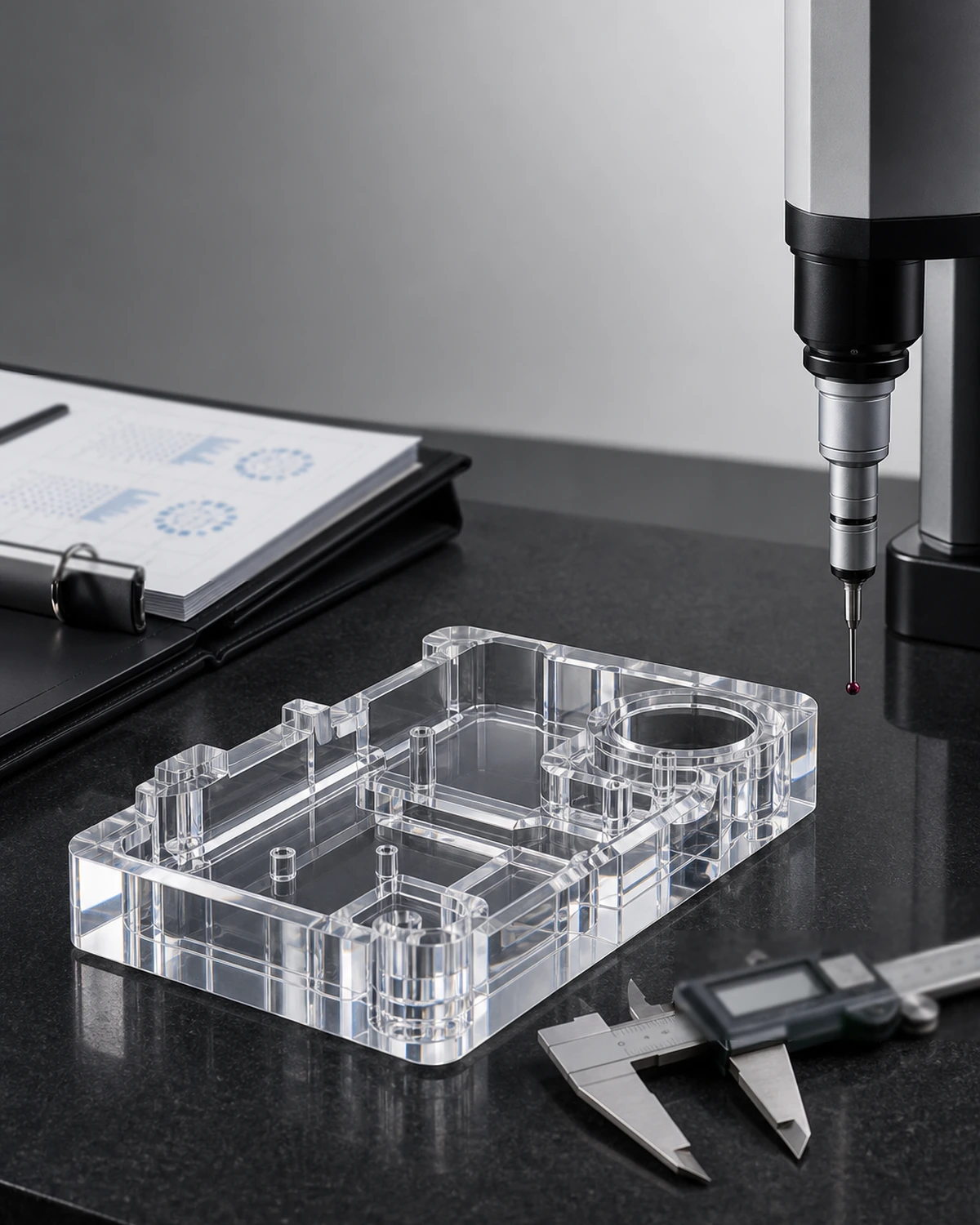

Clear cast-PMMA precision housing on a dark inspection bench beneath a probe, with polished faces and chamfered edges
Program input · MOQ per design
100 pcs
Program input · controls tolerance
Drawing
Program input · production target
15–20 days
Program input · before bulk release
FAI

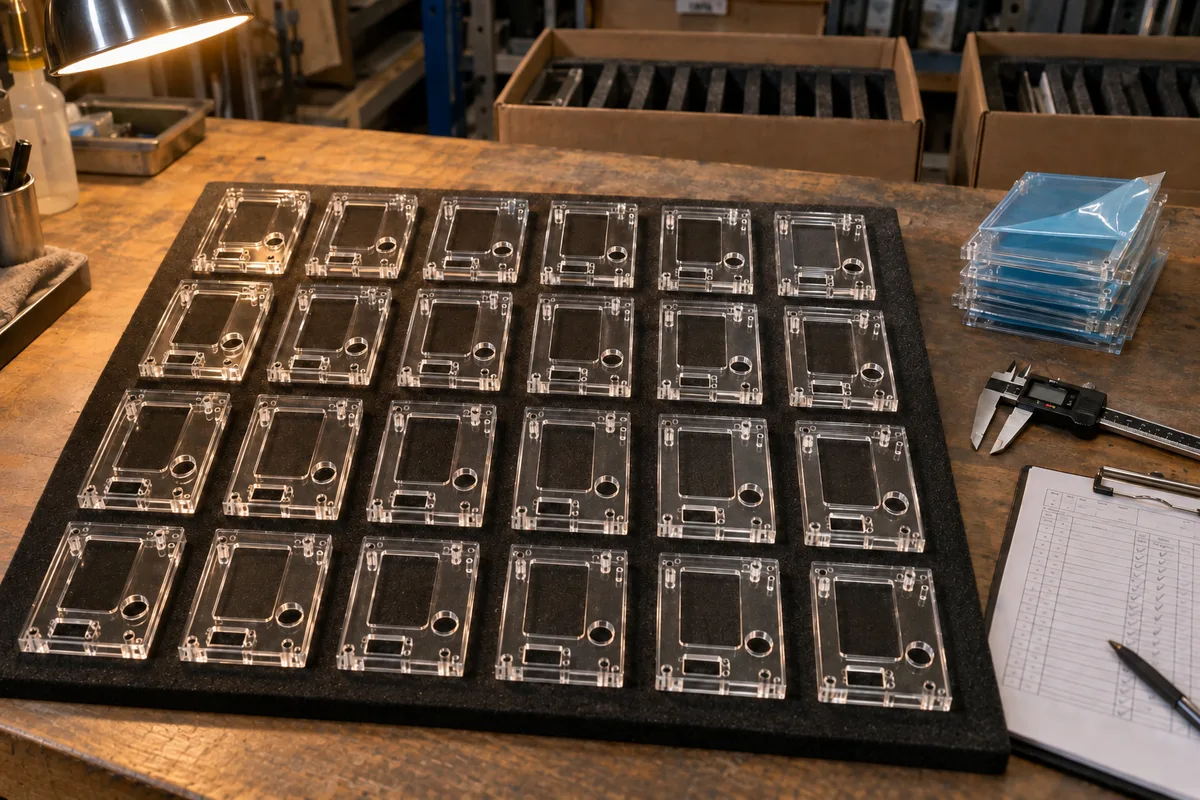

Current ordering baseline, not a featured-project result

100
MOQ (pcs)
3-5d
Sample lead time
15-20d
Production lead time
24h
Quote response

MOQ is 100 pieces per design. Paid samples normally take 3–5 days; sample fees are paid separately and never credited. Standard production takes 15–20 days after the drawing, material, sample, inspection plan, finish, and packing are approved. Wetop responds to a complete brief within 24 hours.

Different-specification price reference: the acrylic cases hub lists a 150 × 100 × 100 mm magnetic-lid case in 3 mm clear acrylic at 500 pieces from $6 per unit FOB Shenzhen. That compact case is not a precision OEM component and is not a quote for this planning model. Geometry, tolerance, material, fixture, finish, inspection, packing, quantity, and destination determine the written quotation.

Key Takeaways

  1. The current production MOQ is 100 pieces per released design; every tolerance remains subject to drawing review and sample capability.
  2. A buyer-approved first-article report defines the measurement method, instrument, sample size, acceptance limits, and release authority.
  3. Material grade, fixture strategy, machining sequence, finish, packing, and inspection frequency belong in one controlled release record.
  4. Controlled file handling can restrict drawing access, while the buyer still owns the qualification decision and the format required by its quality system.

The Brief

A precision-component brief starts with the buyer's released drawing, end use, material requirement, mating parts, measurement method, inspection format, quantity, packing, destination, and revision-control rules. This page does not assign a universal tolerance or claim a completed production result. Geometry, unsupported span, material thickness, machining sequence, finish, and the buyer's assembly all affect what can be held repeatably.

The buyer should identify critical dimensions separately from reference dimensions and state where each feature is measured. A flatness callout without a datum, conditioning state, fixture method, instrument, and permitted result is not ready to quote. If a regulated quality framework applies, the buyer supplies its required report template and retains authority for supplier qualification. Wetop is ISO 9001 certified; this planning model does not claim AS9100 or IATF certification.

Our Recommendation

Build the manufacturing route around the named critical features, not around a generic capability number. The route may include incoming material checks, a dedicated fixture, staged machining, conditioning, finishing, first-article measurement, and a buyer-approved inspection plan. Each step is selected only after the drawing and physical sample show that it is necessary.

Fixture strategy follows the actual geometry

A vacuum fixture, soft jaws, sacrificial support, or another workholding method may be appropriate depending on the part. Wetop reviews clamping force, tool access, unsupported areas, heat, and the risk of marking visible faces before proposing a route. Stress-relief or conditioning is never assumed: if the material, geometry, or end use requires it, the named process conditions and acceptance method are written into the sample plan.

First-article report in the buyer's format

The first-article package should identify the drawing revision, material record, instrument, calibration status, datum scheme, measured sample, results, deviations, and reviewer. The buyer approves the format and decides whether the first article qualifies the supplier or releases bulk production. Wetop can populate a buyer-supplied template or agree a project-specific inspection record without representing it as certification to another quality standard.

Staged checks before final inspection

Critical features can be checked after the operation that creates them instead of waiting for final inspection. The buyer and Wetop agree the sampling frequency, instrument, permitted result, reaction plan, and record retention before release. Cosmetic inspection uses a named lighting condition, viewing distance, surface classification, and approved physical sample rather than an undefined "perfect finish" standard.

Spec Breakdown and Production

A two-variant planning model can share a material family and documentation structure while keeping separate drawings and samples. For a housing panel, the buyer may name an internal pocket, optical face, matte face, edge condition, mating geometry, and critical dimensions. A window panel may instead prioritize visible-face finish, chamfer, clarity, and assembly fit. Thickness and tolerance remain open until the named sheet, span, fixture route, and sample are reviewed.

Standard production is planned at 15–20 days after the drawing, material, first article, finish, inspection plan, and packing are approved. A special sheet, unusually tight measurement requirement, new fixture, conditioning step, or buyer revision can change the schedule. Freight is quoted separately because mode, destination, carton geometry, and delivery terms are project inputs.

The release package should include the approved drawing revision, named material record, first-article report, finish reference, inspection plan, deviation record if any, carton specification, and destination allocation. These records establish what bulk production must match. They do not support a universal reject rate, process capability, tolerance, or audit outcome for another geometry.

Revision ownership matters: the buyer releases the production drawing, and Wetop records any accepted deviation before machining the affected quantity.

Illustrative precision acrylic component cross-sectionConcept cross-section showing a drawing-controlled cast PMMA housing panel, pocket, visible face, rear face, fixture review, optional conditioning route, and buyer-approved inspection record. Geometry is illustrative and not a released specification.Illustrative cast PMMA housing panelDrawing-defined pocket geometryVisible face: finish and tolerance per approved drawingOptical face (polished)Matte rear faceFixture strategy reviewSupport follows actual geometryConditioning if requiredNamed process conditionsValidated on the sampleStaged dimensional checks follow the inspection planBuyer-approved drawing controls acceptanceFirst-article format follows the buyer's quality system
Illustrative route only: the released drawing, fixture review, physical sample, and buyer-approved inspection plan control the component.

Repeat-Order Planning and Revision Control

A follow-on run against unchanged drawings can reuse the approved FAI format, vacuum-bed fixture, stress-relief profile, material source, and inspection plan. That shortens engineering setup and gives the buyer the documentation needed for its own approved-vendor review without claiming qualification before the buyer grants it.

A repeat order can reuse a fixture, program, inspection form, and packing layout only when the buyer confirms that the drawing, material, finish, acceptance method, mating assembly, and destination requirements remain unchanged. Any revision returns to DFM review and may require a new paid sample or first-article record. Reuse can reduce avoidable setup work, but it does not guarantee a fixed price, tolerance, or shortened schedule.

Material traceability should match the buyer's risk. When a named sheet grade or batch record is required, the quote identifies the available supplier document and how the lot is associated with finished parts. Wetop passes supplier documents through without rewriting them as its own test results. The buyer decides whether those records, together with incoming inspection and the first article, satisfy its approved-vendor process.

Planning quantity
100 pieces or more for each drawing-controlled design
Production planning target
15–20 days after signed first-article approval
Dimensional acceptance target
Tolerance confirmed by geometry, material, fixture plan, and sample capability
FAI gate
Buyer-approved report format and first-article measurements before bulk release
Bulk inspection plan
Critical dimensions checked at the agreed frequency with traceable records
Buyer decision point: The measurement method and FAI format must match the buyer’s quality system before bulk parts arrive at its assembly line.
Manufacturing planning noteDrawing-controlled acrylic component program

For technical buyers, the early decisions are the drawing revision, critical-feature list, measurement method, first-article format, sampling plan, and reaction plan. The CNC versus laser cutting guide explains why geometry and edge requirements affect the process choice. The acrylic cases hub provides the different-specification public comparator used above; it does not replace a component drawing or capability review. The acrylic CNC machining service page covers the same drawing controls and quote inputs for a new component program.

Spec'ing a precision acrylic component for an industrial assembly?

Send us the drawing, material requirement, measurement method, first-article format, quantity, packing, and destination. We will return a DFM review, sample plan, inspection outline, and written quote.

Paid sample in 3–5 days, separately paid and never credited · Production in 15–20 days · MOQ 100 pieces per design
